Document 19

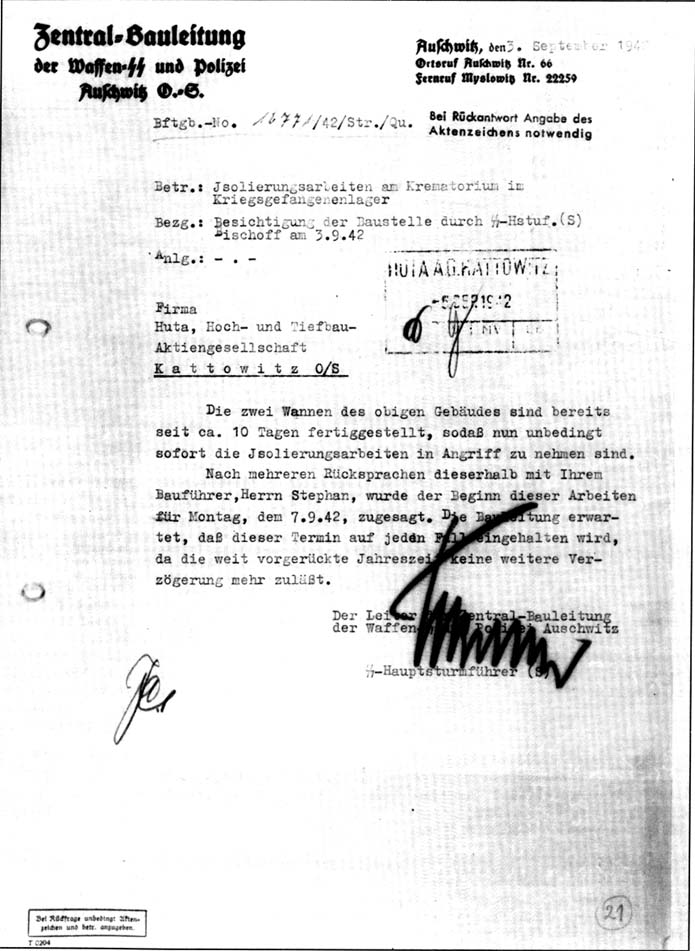

[PMO file BW 30/30, page 21] |
|
|
Translation: |
Waffen SS and Police
Central Construction Management
Auschwitz |
Auschwitz 3rd September 1942 |
|
When replying
quote Reference number |
Correspondence register no. 12771/42/Str/Qu |
Subject: Damp-proofing work in the Krematorium of the POW camp
Reference: Inspection of the worksite by SS Captain (S) Bischoff on 3/9/42
Enclosure/
Huta, Hoch- und Tiefbau-
Aktiengesellschaft
Kattowitz, Upper Silesia
The two excavations for the above building were completed about 10 days ago [since 25th August], so that the damp-proofing work absolutely must begin immediately.
After several conversations on this subject with your foreman Herr Stephan, the start of this work has been fixed for Monday, 7/9/42. The Bauleitung expects this date to be respected without fail, for the lateness of the season allows of no further delay. |
Head of the Waffen SS and Police
Construction Management Auschwitz
[signed] Bischoff
SS Captain (S) |
[initials of a Huta man] |
|
Document 20
[PMO file BW 2/11, neg no 21135/8]
LAGEPLAN DES KRIEGSGEFANGENENLAGERS AUSCHWITZ OS /
Situation plant of Auschwitz POW Camp, Upper Silesia
VORFLUTPLAN/ Plan of drainage ditches
Scale 1:2000
Drawing 1697
Drawn 22/9/42 by prisoner 15592
Checked by SS Second Lieutenant Ertl
and approved by SS Captain Bischoff on the same day
|
The first construction stage was to contain 20,000 prisoners, the second 60,000 and the third 60,000, giving a total of 140,000. |
|
